PRO FIBER
Knowledge BaseField Guide

MW / Cutover Guide

Maintenance Window & Network Transition Procedures

A cutover is one of the highest-risk operations in fiber optic field work. This guide covers every phase — from initial planning through execution to post-cutover closeout — with the step-by-step procedures used on live fiber networks.

1. What is a Cut Over

A cutover is the controlled process of transferring live network traffic from an existing (legacy) fiber infrastructure to a new one. Unlike a fresh installation where no services are running, a cutover happens on a live network — customers are actively using the circuits being moved. This makes it a high-stakes operation where every minute of downtime matters.

Cutovers are required in several scenarios:

  • Migrating subscribers from an old fiber route to a newly built route
  • Replacing damaged or degraded cable segments with new cable
  • Upgrading network architecture (e.g., moving from a point-to-point to a PON design)
  • Relocating infrastructure due to construction, road work, or utility conflicts
  • Consolidating multiple fiber paths into a single optimized route

Key principle: A cutover is NOT an installation. It is a transition. The new infrastructure must be fully built, tested, and validated BEFORE the cutover window begins.

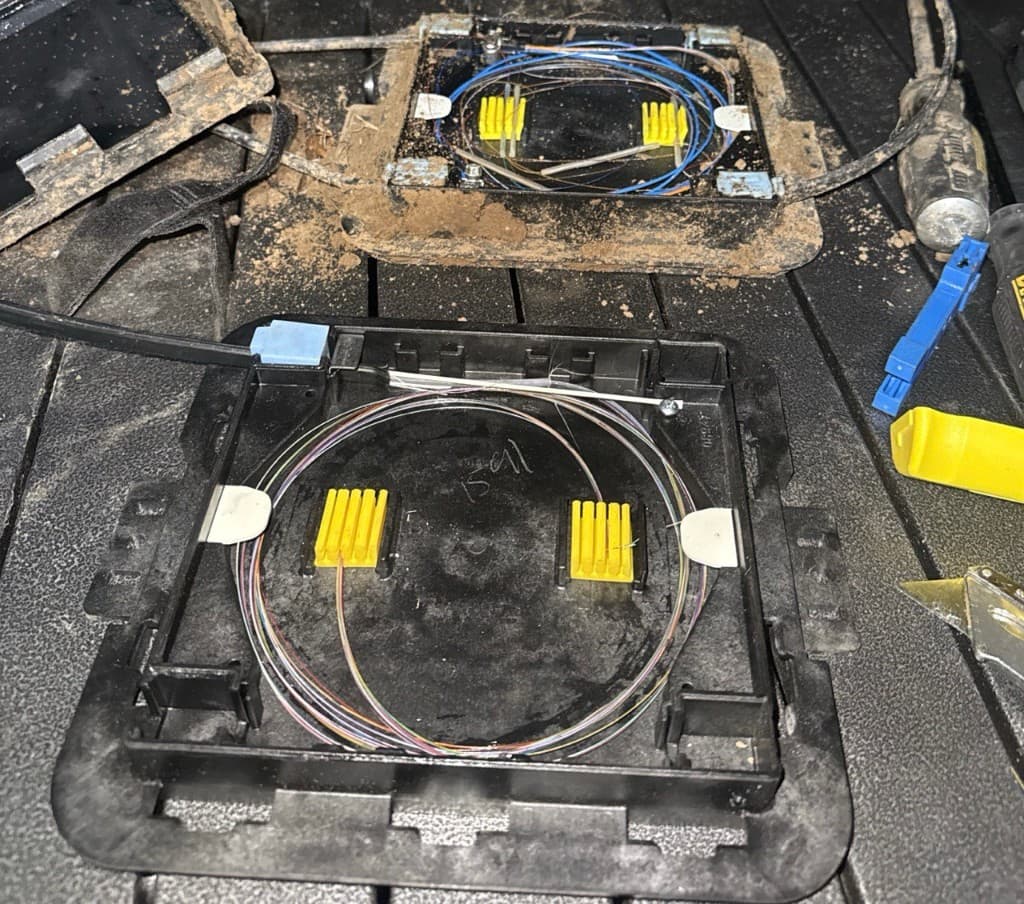

PLP migration — old and new PLP side by side during cutover

Old and new PLP side by side during a cutover migration

The goal of every cutover is zero or minimal service interruption. In practice, this means the actual downtime window — the time between disconnecting the old fiber and lighting up the new fiber — should be measured in minutes, not hours.

2. Pre-Cutover Planning & Checklist

A successful cutover is 90% preparation. The following steps must be completed before any live traffic is moved.

2.1 Scope Definition

  • Identify every circuit, customer, and service affected by the cutover
  • Document the exact fiber pairs being moved (old route → new route)
  • Determine the number of splices, connectors, and enclosures involved
  • Confirm whether the cutover is a full cable swap or individual fiber migration

2.2 New Infrastructure Validation

Before scheduling the cutover, the new fiber path must pass these tests:

  1. OTDR testing — End-to-end trace on every fiber in the new cable. Verify splice losses are within spec (typically ≤ 0.1 dB for fusion splices). Document all events.
  2. Insertion loss testing — Measure total link loss with a calibrated light source and power meter. Compare against the calculated loss budget.
  3. Connector inspection — Every connector in the new path must be cleaned and verified. Clean and re-test until pass criteria are met.
  4. Continuity verification — Use a VFL (Visual Fault Locator) to confirm fiber routing and polarity on every fiber pair.
  5. Label verification — Confirm all splice trays, enclosures, patch panels, and fiber assignments match the design documentation.

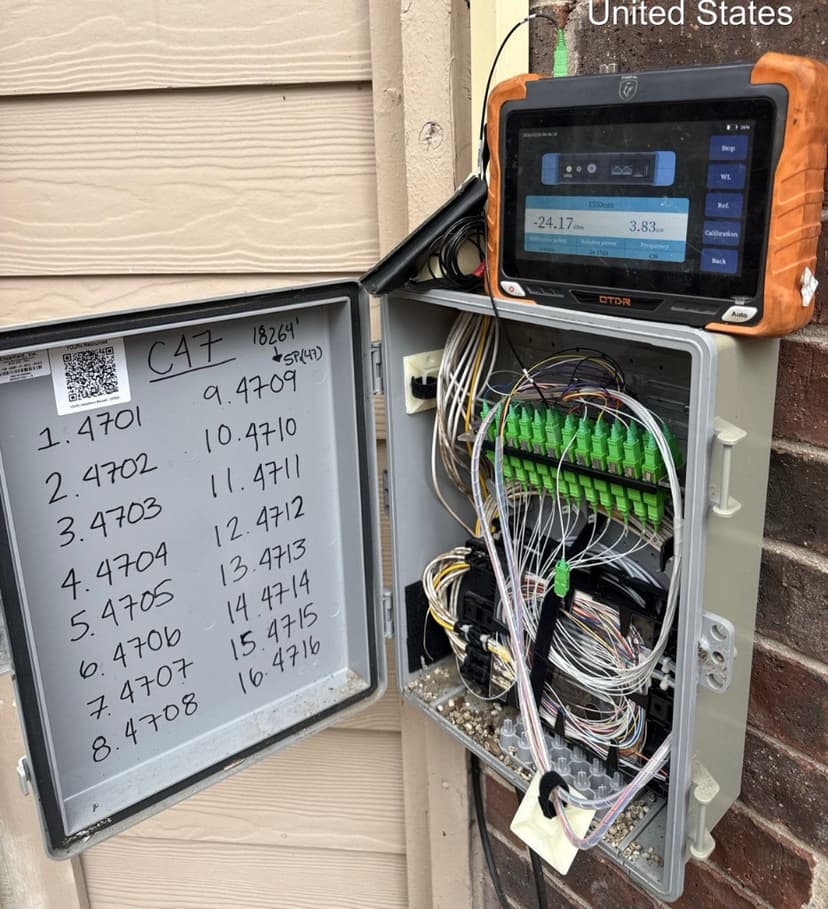

OTDR testing at NDP

OTDR verification at NDP

Cable labels — IN/OUT tags

Label verification — IN/OUT tags

2.3 Cutover Runbook

Create a detailed runbook document that includes:

  • Step-by-step sequence of operations (numbered, no ambiguity)
  • Assigned roles: who performs each step, who verifies
  • Communication plan: who is notified at each stage (NOC, customer, PM)
  • Timing: estimated duration per step, total cutover window
  • Rollback trigger criteria: specific conditions under which you abort
  • Contact list: every person involved with phone numbers

2.4 Pre-Cutover Checklist

  • 1New fiber path fully built and spliced
  • 2OTDR traces completed and saved for every fiber
  • 3Insertion loss test passed on every fiber pair
  • 4All connectors inspected and cleaned
  • 5Labels verified against design documents
  • 6Cutover runbook written and reviewed by lead tech
  • 7Customer / NOC notification sent with maintenance window
  • 8Rollback plan documented and understood by all crew
  • 9All tools and test equipment staged at cutover locations
  • 10Spare fibers, splice sleeves, and enclosure hardware on-site
  • 11Communication channel established (radio/phone/group chat)
  • 12Weather and site access confirmed

3. Day-of Execution — Step by Step

On cutover day, follow the runbook exactly. No improvisation. Every step is performed, verified, and acknowledged before moving to the next.

Step 1 — Pre-Start Briefing

  • Gather all crew at staging area. Review the runbook together.
  • Confirm roles: who is at which location, who calls what, who is lead tech.
  • Verify all tools and equipment are present and functional.
  • Confirm communication channels are working (test radio/phone).
  • Verify the maintenance window is active and NOC is aware.

Step 2 — Final Pre-Cutover Tests

  • Run a final OTDR trace on the new fiber path — compare to baseline.
  • Verify light levels on the existing (old) path as a baseline for comparison.
  • Confirm all splice enclosures on the new path are sealed and secure.
  • Take photos of all connection points before any changes are made.

Step 3 — Notify and Confirm Go/No-Go

  • Contact NOC / project manager: "We are ready to begin cutover."
  • Wait for explicit GO confirmation before proceeding.
  • If any pre-cutover test failed → do NOT proceed. Execute rollback.
  • Log the exact time of GO confirmation.

Step 4 — Disconnect Old Path

  • At the designated splice point or patch panel, disconnect the old fiber pairs.
  • Work in the sequence defined in the runbook — one circuit at a time when possible.
  • Immediately protect disconnected fiber ends with dust caps.
  • Log the exact time of each disconnection.

Step 5 — Connect New Path

  • Connect the pre-tested new fiber pairs at the patch panel or splice point.
  • Clean every connector immediately before mating — even if cleaned earlier.
  • Verify polarity (TX → RX) on every connection.
  • Log the exact time of each connection.

Step 6 — Immediate Light-Level Verification

  • As soon as connections are made, measure receive power at the far end.
  • Compare to the expected value from pre-cutover loss budget calculations.
  • If power is within spec → proceed. If not → troubleshoot immediately.
  • Report light levels to NOC / PM.

Step 7 — Service Verification

  • NOC or customer confirms services are operational on the new path.
  • If multi-circuit cutover, verify each circuit individually.
  • Do NOT close splice enclosures or leave the site until all services are confirmed UP.
  • Log confirmation time for each circuit.

4. Post-Cutover Verification

After all services are confirmed up, perform these verification steps before leaving the site:

4.1 Testing

  1. Power meter check at NIU — Measure receive power at the NIU with VeEX. Must be above LL threshold for the technology (GPON: -22.0 dBm, XGS-PON: -22.0 dBm, Go-Long: -28.0 dBm).
  2. OTDR trace on the completed cutover path — Run OTDR to verify all splice losses are within spec. Compare to pre-cutover traces if available.
  3. Service-level verification — Confirm with NOC that all circuits are passing traffic normally, bandwidth is nominal, and no alarms are present.

4.2 Physical Inspection

  • All splice enclosures properly sealed (IP68 rating maintained)
  • All patch panel connections seated fully, dust caps on unused ports
  • Cable routing is clean — no kinks, no tight bends, proper radius maintained
  • All cable ties and supports installed, no hanging or unsupported cable
  • Old (decommissioned) fibers properly capped, labeled as inactive, or removed

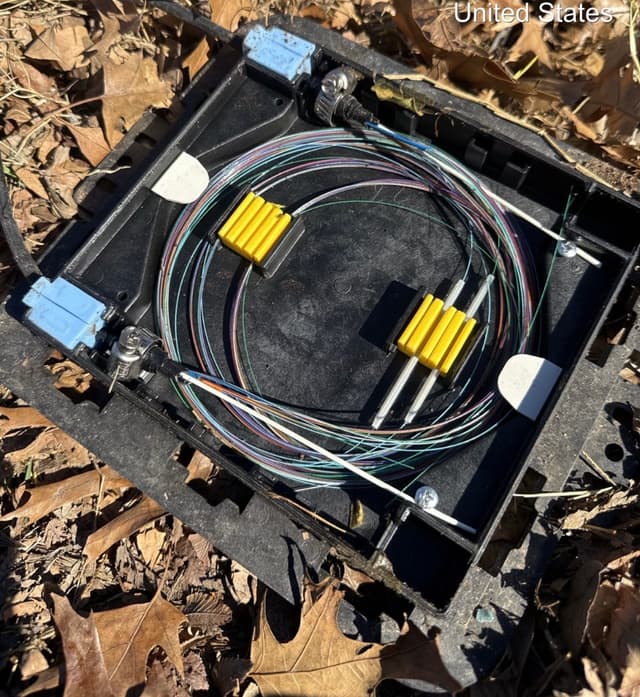

PLP splice tray organized

PLP — organized splice tray

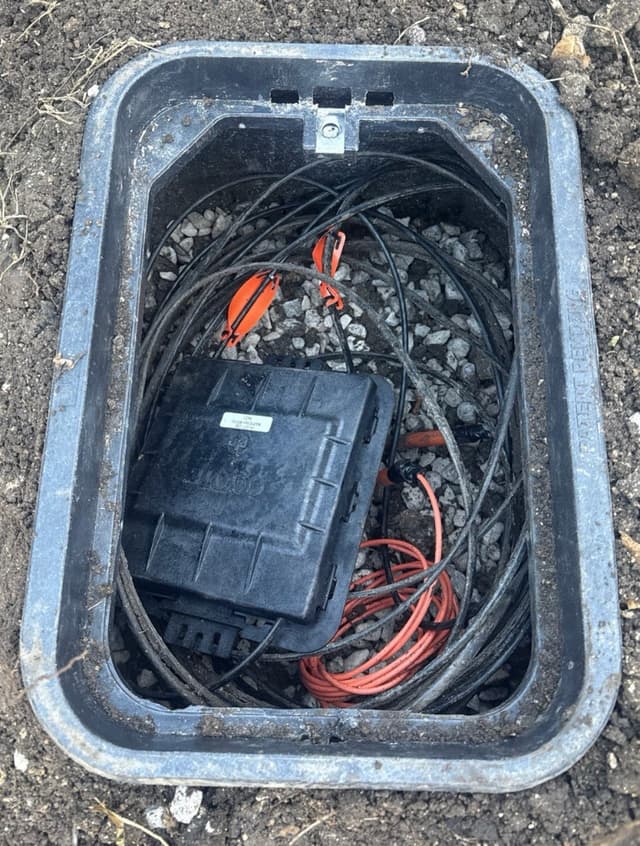

Small vault — PLP secured

Vault — PLP secured inside

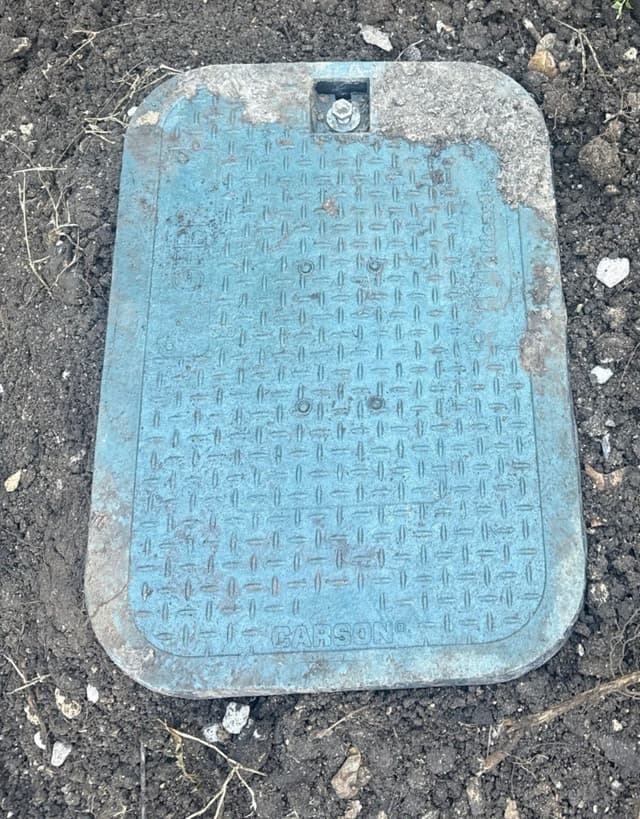

Vault lid closed and bolted

Vault lid closed and bolted

4.3 Soak Period

After the cutover, NOC monitors the new path for 10–15 minutes. If all circuits come back up clean — no alarms, no loss, levels are good — it's hands off. You're done.

  • Stay on-site during the soak — NOC may need you to re-check a port or clean a connector
  • If something doesn't come up, troubleshoot immediately while the MW is still active
  • Once NOC confirms all clear, pack up and close the ticket

5. Rollback Procedures

A rollback means reverting to the old path. It is a safety net, not a failure. Knowing when and how to rollback is a critical skill.

5.1 When to Rollback

Trigger a rollback if any of these conditions are met during or after cutover:

  • Light levels on the new path are outside acceptable range and cannot be remediated on-site
  • Services do not come up within the defined maintenance window
  • Multiple circuits fail simultaneously on the new path
  • Physical damage is discovered on the new route during cutover
  • Project manager or NOC explicitly calls for rollback

5.2 Rollback Steps

  1. Announce to all crew and NOC: "Initiating rollback."
  2. Disconnect the new path connections.
  3. Clean the old fiber connectors (they should still have dust caps from Step 4).
  4. Re-connect the old fiber pairs in the original configuration.
  5. Verify light levels on the restored old path.
  6. Confirm with NOC that services are back to normal on the old path.
  7. Log all rollback times and reasons.
  8. Conduct a debrief to determine root cause and plan re-attempt.

6. Documentation & Closeout

Every cutover must produce a complete documentation package. This is not optional — it is how future crews maintain the network.

6.1 Required Documentation

  • Cutover completion report — Summary of what was done, when, by whom
  • OTDR traces — Pre-cutover (baseline) and post-cutover for every fiber
  • Insertion loss test results — Per-fiber actual vs. budgeted loss
  • Splice records — Splice tray diagrams showing old-to-new fiber mapping
  • Photos — Before and after at every work location
  • As-built drawings — Updated route maps reflecting the new configuration
  • Time log — Start/end of each step, total downtime per circuit
  • Issues log — Any problems encountered and how they were resolved

6.2 Handoff

Deliver the documentation package to the project manager and network operations team. Confirm that all as-built records in the GIS/mapping system have been updated. The cutover is not complete until documentation is accepted.

Field Standards

LL thresholds, splice & connector criteria, attenuation tables
